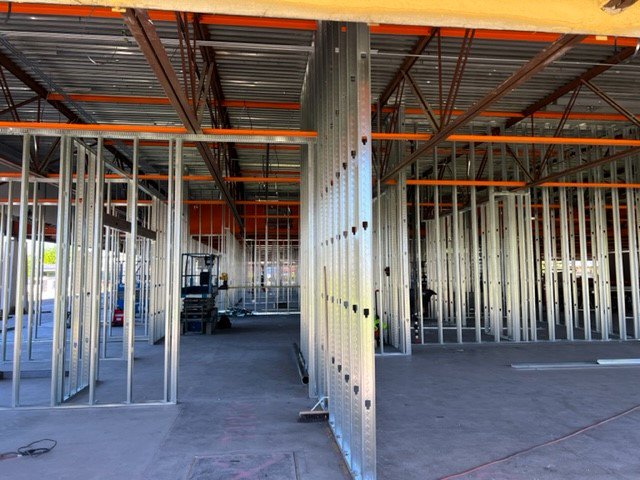

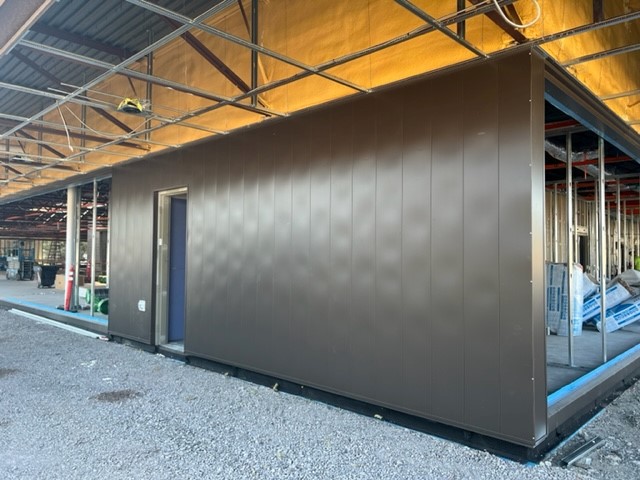

(2021) Active Projects

Scope: Renovation of 47,000 square foot education building
Funding: UPE 803 / XI-Q Bond
Status: Design Underway
Start Date: August 2021
Completion Date: December 2022

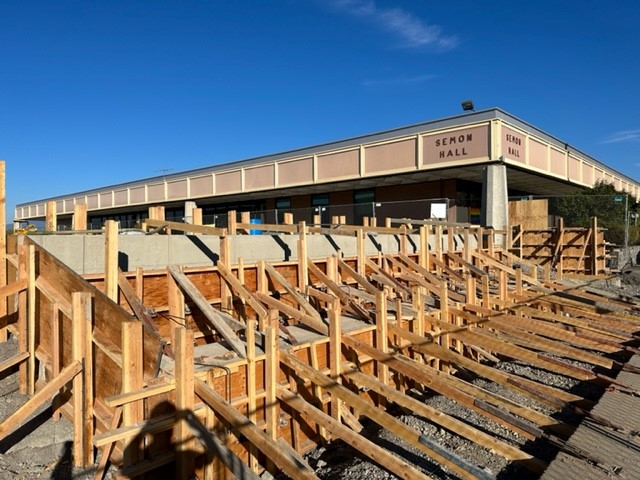

Boivin Hall

Scope: New roundabout at Campus Way-Dan O'Brien intersection
Funding: UPE 803 / XI-Q Bond
Status: Design 90% complete
Start Date: June 2021
Completion Date: September 2021

Campus Way

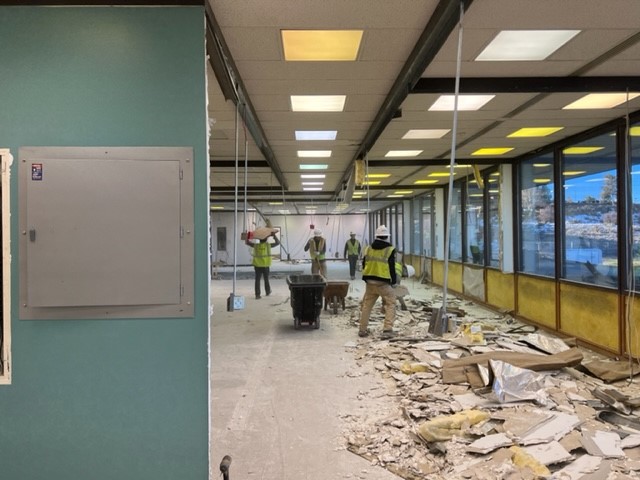

Scope: Completion of two unfinished spaces in the lower level of DOW
Funding: Program funded / DPT001
Status: Design underway
Start Date: June 2021
Completion Date: September 2021

DOW Physical Therapy Department

Scope: Addition to existing building
Funding: Department funded / SHS301 and SHS601
Status: Design 70% complete
Start Date: June 2021
Completion Date: December 2021

ISHC

Scope: Renovation of OT track facility
Funding: Will provide when available
Status: Design completed
Start Date: May 2021
Completion Date: September 2021

Stadium

Scope: Partial exterior renovation of existing building
Funding: UPE 797 / Capital Improvement and Renovation (CIR)
Status: Design underway
Start Date: June 2021
Completion Date: September 2021

Snell Hall

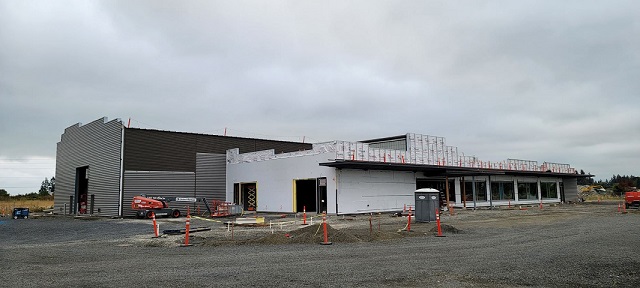

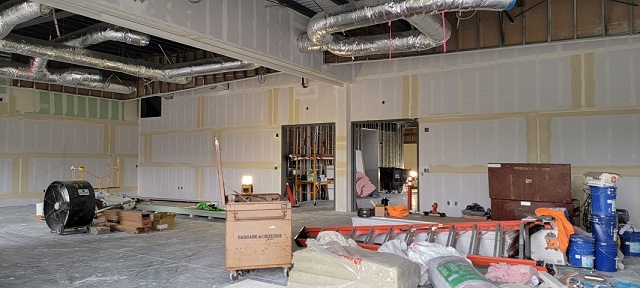

(2020) Active Projects

The new building will be home to the expanded interdisciplinary College of Engineering and Technology, including the departments of: Manufacturing and Mechanical Engineering Technology (MMET), Civil Engineering (CE), Electrical Engineering & Renewable Energy (EERE), Computer Systems Engineering Technology (CSET), Geomatics, Management, and Oregon Renewable Energy Center (OREC).

The project includes 70,000 GSF of new classroom and lab spaces organized around a central “Commons” area. Both the upper and lower levels have multiple labs, with integrated lab support spaces and classrooms. The lower level includes an auditorium, multiple offices and multiple conference/meeting rooms. The upper level includes a large conference room with adjacent breakout rooms, multiple offices and a café at the main entry.

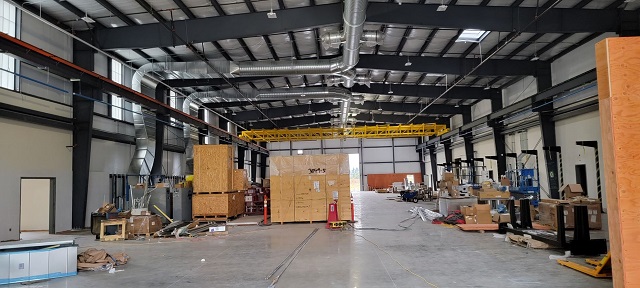

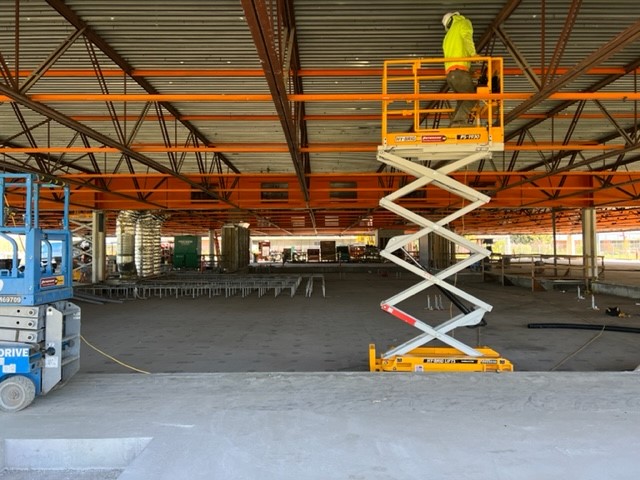

The CEET construction is underway and the project is currently 55% complete. Construction is anticipated to be substantially complete in August of 2021.

  • Scope: New 70,000 square foot education building
  • Funding: UPE 785 / XI-Q Bond
  • Status: 55% completed
  • Start Date: January 2020
  • Completion Date: August 2021
